EDI Migrations: Risks, Timelines, and How Projects Actually Fail

Posted by Brooke Lester on Aug 5, 2026 1:41 PM

Business team reviewing data on laptop together

Most EDI migration timelines are wrong before the project even kicks off. The vendor's estimate looked reasonable on paper, but it didn't account for your custom maps, the trading partner certification queue, or the fact that your EDI specialist is already running at capacity just keeping the current environment stable.

By the time those gaps surface, you're three months in, chargebacks are stacking, and someone's having a difficult conversation with leadership about a supply chain disruption.

An EDI migration is the process of moving your electronic data interchange environment from one platform, version, or architecture to another, including translating maps, re-establishing trading partner connections, validating transaction sets, and cutting over without disrupting active supply chain operations.

On paper, that sounds manageable. In practice, the scope almost always expands once you actually audit what's in your environment.

Here's an honest look at where migrations go sideways and what it takes to get through one without the firefighting.

Why Do So Many EDI Migrations Go Over Time and Over Budget?

The short answer is that most migrations are scoped before anyone fully understands what's in the environment. The longer answer involves a few specific failure modes that show up on nearly every distressed project we've seen.

The Map Debt Problem

Legacy EDI environments accumulate custom maps over years, and most of them aren't well documented. When teams run an actual audit before a migration, scope surprises are the rule, not the exception. Maps that were supposed to take two weeks to convert turn into six, because half of them have workarounds nobody remembered building.

The Bus Factor

If your EDI environment runs because one person understands it, a migration will expose that fast. When that person carries both BAU support and the migration simultaneously, the knowledge gap that emerges when they're overloaded can add months to your timeline — and that exposure is live, with your supply chain running the whole time. If that person then walks out mid-project, the recovery timeline gets even longer.

Vendor Timelines vs. Reality

Out-of-the-box estimates don't account for trading partner certification queues, exception handling, or retrofitting the workarounds baked into the old system. Vendors scope what they control. Everything else is your problem.

ERP Dependencies

When an ERP upgrade is driving the migration, EDI often gets treated as a downstream task. It gets scoped late, resourced late, and then suddenly it's blocking go-live, and everyone's looking for someone to blame.

The table above shows where the time actually goes versus what the initial estimate usually assumes.

What Does a Migration Actually Cost When It Fails?

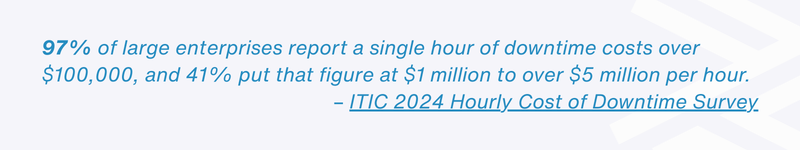

97% of enterprises face $100K+ hourly downtime costs

Delayed migrations aren't just a scheduling problem. When your EDI environment is mid-cutover and something breaks, the financial exposure adds up fast from several directions at once.

Chargebacks from missed ASNs (EDI 856) start accumulating the moment your trading partners stop receiving timely ship notices. Retailers and large buyers have SLAs, and they enforce them regardless of what's happening in your IT environment.

Meanwhile, the manual intervention required to keep transactions moving during a frozen cutover window carries its own cost.

Trading partner attrition is a slower but equally real problem. If your certification timelines drag, some partners will route around you or escalate to your leadership. That kind of friction doesn't always repair cleanly after the migration closes.

Internal team burnout is worth naming, too. Migration firefighting on top of ongoing support work is a retention problem dressed up as a scheduling one. Teams that have been through a badly managed cutover often lose people right after it's over.

What Does a Realistic Migration Timeline Actually Look Like?

Most EDI migrations take four to six months from discovery to stabilization. Complex environments with hundreds of trading partners or significant map debt run longer.

Here's a working breakdown of what each phase realistically requires.

Any of the following can compress these timelines significantly:

  • Automated map conversion tools can cut the map build phase from months to weeks.
  • Parallel testing with a dedicated trading partner liaison keeps certification moving instead of waiting on whoever picks up the phone at each TP.
  • Architectural planning that accounts for exception handling from the start prevents the last-minute scrambles that always seem to happen the week before cutover.

edi-migrations-risks-timelines-and-how-projects-actually-fail-callout-2

How Does Remedi Approach Migrations Differently?

Remedi has been working through EDI migrations for more than 30 years. We’ve seen clean ones, complex ones, and a fair number of rescues. A few things in our approach tend to make the biggest difference.

Faster Timelines Through Purpose-Built Methodology

Remedi's migration approach uses proven IBM-verified architecture and purpose-built processes that deploy significantly faster than starting from scratch. One wholesale client cut their map migration from a projected nine months to one to two months — and a Fortune 500 building products company managing EDI across 33 countries stood up a new integration environment in a fraction of the standard time.

Co-Sourcing with Retained Control

Remedi acts as an extension of your IT team. With co-sourcing, you retain ownership and licensing of your integration software; there's no lock-in to a proprietary ecosystem. We manage the environment and monitor transactions while you keep control of your supply chain data.

After-Hours Availability

When a migration goes sideways on a Friday night, as they sometimes do, Remedi consultants pick up the phone. We've salvaged migrations that failed at go-live and had clients operational again by the next business window. That kind of coverage matters when your trading partners don't stop sending transactions because you had a bad cutover.

For a closer look at what managed migration support involves, see our posts on overcoming common EDI challenges and migrating on-premises EDI infrastructure to the cloud.

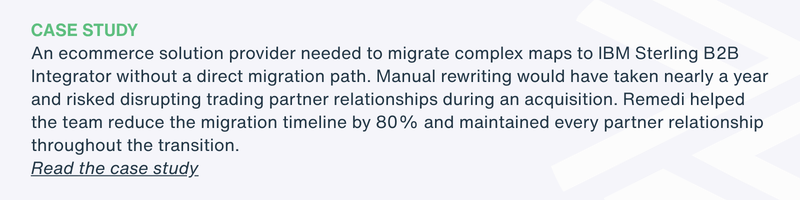

Ecommerce B2B migration case study: 80% faster timeline

Ready to Figure Out What Your Migration Actually Involves?

For more than 30 years, Remedi has been helping companies get through EDI migrations and avoid the ones that would have gone badly. If you're planning a platform consolidation, managing an M&A that tripled your trading partner list overnight, or trying to get off a Gentran environment before it becomes a security liability, we're glad to take a look at what you're working with.

We offer consulting, co-sourcing, and managed services, so you can get the right level of support without handing over control of your environment. If you want to talk through where your project stands, contact Remedi today.

Woman envisioning platform migration with Remedi

Frequently Asked Questions

How long does an EDI migration typically take? Most EDI migrations take four to six months from discovery to stabilization, though complex environments with hundreds of trading partners or significant map debt can run longer. The biggest variable is trading partner certification — that queue is rarely in your control, and it's the phase most timelines underestimate.

What causes EDI migration projects to fail? The most common causes are underestimated map complexity, under-resourced internal teams, ERP project dependencies that treat EDI as an afterthought, and trading partner certification delays. Most of these are foreseeable with a proper pre-migration audit. The projects that go badly usually skipped that step.

Should we handle an EDI migration in-house or bring in outside help? That depends on your internal team's bandwidth and how complex your environment is. If you have one or two EDI specialists already running full tilt on BAU support, pulling them into a migration will strain both efforts. A co-sourcing model lets you bring in specialized expertise without surrendering control of your system or your data.

Can we migrate off Gentran without losing our existing maps? Yes. Automated conversion tools translate maps from Gentran:Server for UNIX to IBM B2B Integrator formats, eliminating the need to rewrite them from scratch. One client cut their map migration timeline by 80% using this approach while maintaining all existing trading partner relationships through an acquisition.

New IT hires in specialized roles typically take six to twelve months to reach full productivity — and that's under normal conditions.
